Signal Mountain Driveway Transformation: Cracked Asphalt to Slate-Stamped Concrete

How we replaced a failing asphalt driveway on Signal Mountain with a hand-tooled slate-stamped concrete masterpiece — on-site every day.

Arthur Vance 6 min read
Finished Ashlar slate stamped concrete driveway on a steep Signal Mountain lot

The call came in March. A Signal Mountain homeowner had an asphalt driveway that had been patched three times in six years and was losing the argument. Alligator cracking across most of the surface, weeds coming through the seams, and a low spot near the garage that held water every time it rained.

They had two questions. Could concrete work on a grade like theirs, and would it look like anything.

What we found on the walkthrough

The lot runs at roughly a twelve percent grade from the street to the house, which is normal up here and completely normal for us. What mattered more was what sat under the asphalt.

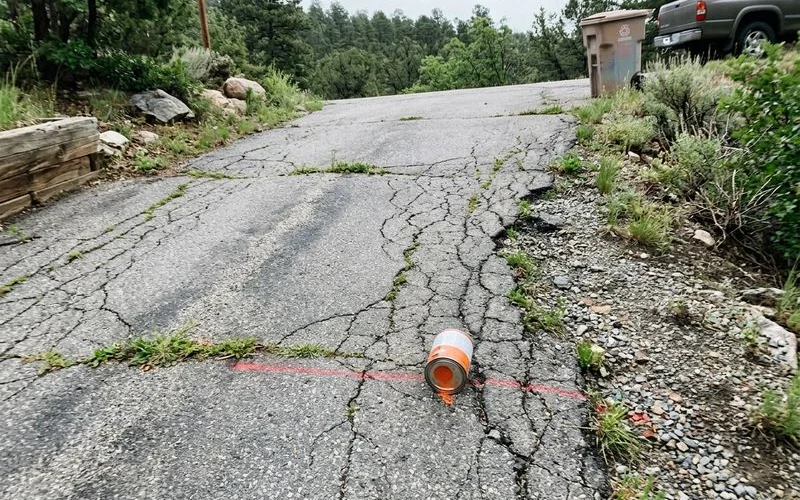

The original cracked asphalt driveway before demolition

Asphalt is flexible, which means it telegraphs base problems rather than bridging them. The pattern of cracking told me the base had never been properly compacted, and the low spot near the garage confirmed it: that section had settled. Any surface we put down over that base would repeat the same failure, so the base was coming out.

The other issue was water. Runoff from the upper part of the lot was sheeting across the drive during heavy rain and disappearing along the low edge, which is exactly how a base gets undermined. That needed solving before anything decorative went on top.

The rule on mountain lots

Water beats concrete every time if you let it. Grade the slab to move water where you want it, and give it somewhere to go, before you think about pattern and color.

The build

Demolition took a day and a half, including haul-away. Below the asphalt we found four inches of loose, uncompacted fill over clay, which explained everything. We excavated to competent subgrade and brought in crushed stone, compacting it in lifts rather than dumping and rolling once.

Reinforcement went up a level from a standard flat-lot spec. On a twelve percent grade with vehicle loads, we tied a #5 rebar grid on chairs so the steel sat inside the slab where it does structural work, not underneath it where it does nothing. Along the uphill edge we set a channel drain tied into a swale that carries runoff around the slab and down to the tree line.

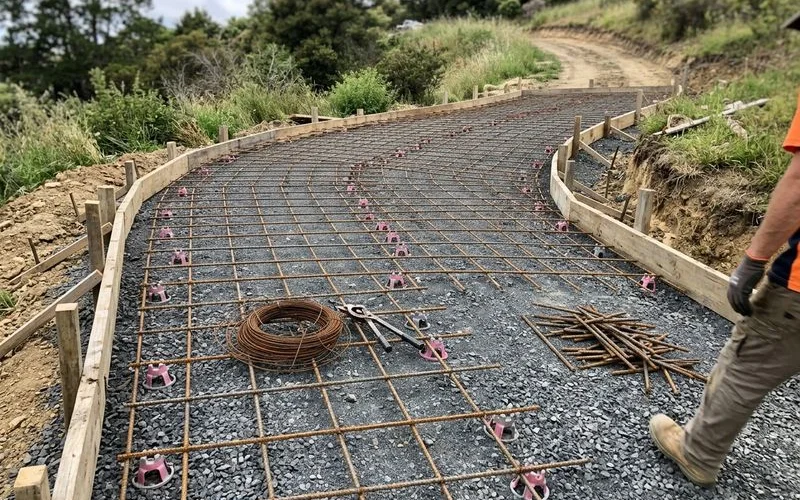

Heavy #5 rebar grid tied on chairs over the compacted stone base

Pour day is the one that decides whether a project like this works. Concrete placed on a slope has a working window that closes fast, and there is no second attempt. We booked an early plant slot to beat the afternoon heat, placed in staged sections working downhill, and screeded each section before moving on.

The stamp was Ashlar slate with a two-tone integral color and a hand-applied antiquing release brushed into the low points. Along the perimeter we ran a contrasting picture-frame border, which frames the drive and gives the eye somewhere to stop where the slab meets the landscaping.

StageDays on siteWhy it mattered
Demolition and haul-away1.5Removed the failed base, not just the surface
Base, drainage, steel2Compacted lifts, channel drain, #5 grid on chairs
Pour, color, stamp1Staged placement downhill inside the working window
Wash, joints, seal2Saw-cut joints laid out with the pattern, sealed after cure

The finish and the traction question

The homeowner’s one hesitation about a stamped drive on a grade was traction in the wet. Fair question. Textured stamped surfaces grip better than smooth troweled concrete to begin with, and we added a micronized slip-resistant additive into the high-solids acrylic sealer, which keeps grip without changing the look.

Saw-cut control joints went in on a tighter spacing than a flat lot would need, laid out to follow the stamp pattern so they read as grout lines rather than as cracks. That is the detail people notice without knowing why the drive looks intentional.

What I would tell the next homeowner up there

Most of the money and most of the days on this project went into things you cannot see: base excavation, compaction, drainage, and steel. The stamping was one day. That ratio is not a mistake. A beautiful surface over a bad base is a countdown, and on a mountain grade the countdown is shorter.

If your drive is cracking in a pattern rather than in one place, look underneath before you look at finishes.

Thinking about a decorative driveway on a mountain lot?See our stamped and decorative concrete work

  • #stamped-concrete
  • #driveway
  • #signal-mountain
  • #case-study
Related service

Stamped & Decorative Concrete

Custom stamped patterns and decorative finishes that turn concrete into a durable, artistic surface.

See Stamped Concrete
Arthur Vance
Written by

Arthur Vance

Founder & Master Concrete Craftsman

Arthur Vance founded Vances Concrete Craft in Chattanooga, TN in 2007 after a decade on large commercial crews. As a solo master craftsman, he is on-site for every pour, hand-tooling stamped, stained, and structural concrete across Hamilton County.

Tennessee Contractor License #00684219

Related

More from the job site

Booking 4-8 weeks out — reserve your project date

Thinking about your own project?

Book a free in-person design consultation with Arthur. He measures, checks the subgrade, and gives you a firm itemized quote.

  • Licensed, bonded & insured
  • Free in-person design consultation
  • Owner on-site for every pour
